Fiber Optic Installation Process: A Step-By-Step Walkthrough

Whether you’re upgrading a corporate office, a retail location, or an entire campus, understanding the fiber optic installation process starts with knowing what actually happens on-site. It’s not as simple as plugging in a cable. There’s route planning, cable pulling, termination, and testing, each step requiring skilled hands and the right equipment.

At MegaServices, our technicians handle low voltage structured cabling and fiber optic work for AV integrators and project managers across the U.S. and Canada. We’ve supported thousands of installations since 2007, so we know exactly where projects stall and where they succeed. That experience shapes this guide.

Below, we’ll walk you through every stage of a professional fiber optic installation, from the outside plant work to the final hardware setup indoors. By the end, you’ll know what to expect, what questions to ask, and how to keep your project on track from start to finish.

What happens in a fiber internet install

A fiber optic installation process breaks into two distinct phases: outside plant (OSP) work and inside plant (ISP) work. OSP covers everything from the provider’s network to the exterior of your building. ISP covers the cable path inside your building, the termination hardware, and the final network equipment. Both phases have to be coordinated properly, or you end up with delays, rework, and unhappy stakeholders.

Getting both phases right requires clear communication between the carrier, the integrator, and the on-site technician before a single cable is pulled.

The two main phases of a fiber install

Outside plant work includes trenching or aerial strand, running the fiber drop to the building’s demarcation point, and sometimes installing a handhole or conduit for future access. Providers or their subcontractors typically own this phase, and it sets the physical foundation for everything that follows.

The two main phases of a fiber install

Inside plant work picks up at the point where fiber enters the building. Your technician routes the cable to the Optical Network Terminal (ONT), terminates and splices as needed, and then connects the ONT to your gateway or router. This phase also includes performance validation, where the technician tests signal levels, throughput, and latency before handing off the network.

What controls the timeline

Several variables determine how long a fiber install takes from start to finish. Building type matters significantly: a single-story retail location is far simpler than a multi-tenant office building with concrete floors. Conduit availability is another key factor. If existing conduit runs to the right locations, the install moves fast. If your team needs to pull new conduit and drill through walls, plan for extra time.

Here’s a quick breakdown of what affects install duration:

FactorImpact on Timeline
Existing conduitShortens install significantly
Building sizeLarger buildings need more cable runs
Provider lead timeCan add days or weeks before work starts
Number of dropsEach additional drop adds labor hours

Step 1. Confirm service type and plan the route

Before anyone touches a cable, you need to confirm what type of fiber service is being delivered and where it enters the building. Every fiber optic installation process starts here, because FTTH, FTTB, and FTTC each carry different infrastructure requirements, and knowing which service you have determines where the provider’s responsibility ends and yours begins.

Identify your service type and demarcation point

Your demarcation point is where the provider’s network hands off to your equipment. In most commercial installs, this is a utility room or telecom closet near the building’s entry point. Confirming this location early prevents confusion later when cables are being pulled and terminated.

Lock down the demarcation point with your provider in writing before scheduling any on-site labor.

Conduct a site survey and map the route

Walk the full cable path from the building entry to the final equipment location before the install date. Note any obstacles: concrete walls, existing conduit, fire-rated barriers, or elevator shafts. Document your findings in a simple route map so every technician on the job knows the plan going in.

Use this checklist during your site survey:

  • Confirm entry point and conduit availability
  • Measure the total cable run distance
  • Identify any penetrations needed through walls or floors
  • Note fire-stop requirements at each wall penetration

Step 2. Run the drop to the building

Once your route is mapped, the outside plant crew runs the fiber drop from the provider’s distribution point to your building’s entry. This is where the fiber optic installation process gets physical, and the quality of work here directly affects signal reliability for years to come.

Choose the right cable path and method

Your crew will use one of two main delivery methods depending on your site: aerial or direct-buried. Aerial runs attach the fiber to a messenger strand between utility poles. Direct-buried runs require trenching, which takes longer but protects the cable from weather and physical damage. For most commercial sites, trenched conduit is the preferred approach because it gives you a protected pathway and easier access for future repairs.

Choose the right cable path and method

Here are the key decisions your crew needs to make before pulling the drop:

  • Confirm burial depth meets local code (typically 18 to 24 inches for fiber)
  • Use innerduct inside conduit to protect the cable
  • Seal all conduit entry points to prevent moisture intrusion
  • Label the cable at both ends before burial or attachment

Protect the cable at the building entry

Your technician needs to seal and weatherproof the point where fiber enters the building. Use an approved grounding bushing and a drip loop on aerial entries to prevent water from tracking along the cable into your facility.

A poor entry point is one of the most common causes of signal loss on commercial fiber installs.

Step 3. Bring fiber inside and install the ONT

Once the drop is secured at the building entry, your technician routes the fiber cable from the entry point to the Optical Network Terminal (ONT) location. This leg of the fiber optic installation process covers the interior cable run, the ONT mounting, and the final connection. Getting this right matters because a damaged interior run creates problems that are difficult to trace later.

Route the interior cable properly

Your technician should follow existing conduit or cable trays wherever possible to protect the fiber. Fiber has a minimum bend radius (typically 10x the cable diameter) that must be respected at every corner. Violating that bend radius causes signal loss that won’t always appear immediately but degrades performance over time.

Never pull fiber with the same tension limits you would use on copper: fiber requires gentler handling to avoid microbends.

Mount and connect the ONT

Your technician mounts the ONT on a flat, accessible wall surface near a power outlet and close to where fiber enters the room. After securing it, they connect the fiber strand to the ONT’s SC/APC or SC/UPC port, depending on the equipment spec. Use this checklist before powering the ONT on:

  • Verify the connector type matches the ONT port
  • Clean the fiber end-face before insertion
  • Confirm the ONT has power and a stable signal light

Step 4. Set up the gateway and validate performance

With the ONT active and showing a stable signal, your technician connects the gateway to complete the fiber optic installation process. This final stage ties the provider’s network to your internal infrastructure and confirms the connection actually delivers what the service plan promises.

Connect and configure the gateway

Your technician runs an Ethernet cable from the ONT’s LAN port to the WAN port on your gateway or router. Power on the gateway and allow two to three minutes for it to pull an IP address from the provider’s network. If the gateway doesn’t establish a connection automatically, your technician should verify the ONT’s LAN port configuration matches the gateway’s expected input, as some providers require a specific VLAN tag or authentication credential.

Confirm your gateway’s WAN settings with the provider before the install date to avoid delays during commissioning.

Run performance validation tests

Once the gateway is online, run a structured set of tests to confirm the link performs at spec before you sign off on the job.

Use this validation checklist:

  • Run a speed test from a wired device to confirm upload and download match your plan tier
  • Ping the provider’s gateway to check latency (target under 10ms for most fiber services)
  • Test for packet loss over a 60-second continuous ping
  • Verify Wi-Fi signal from at least three points in the space if wireless coverage is part of the scope

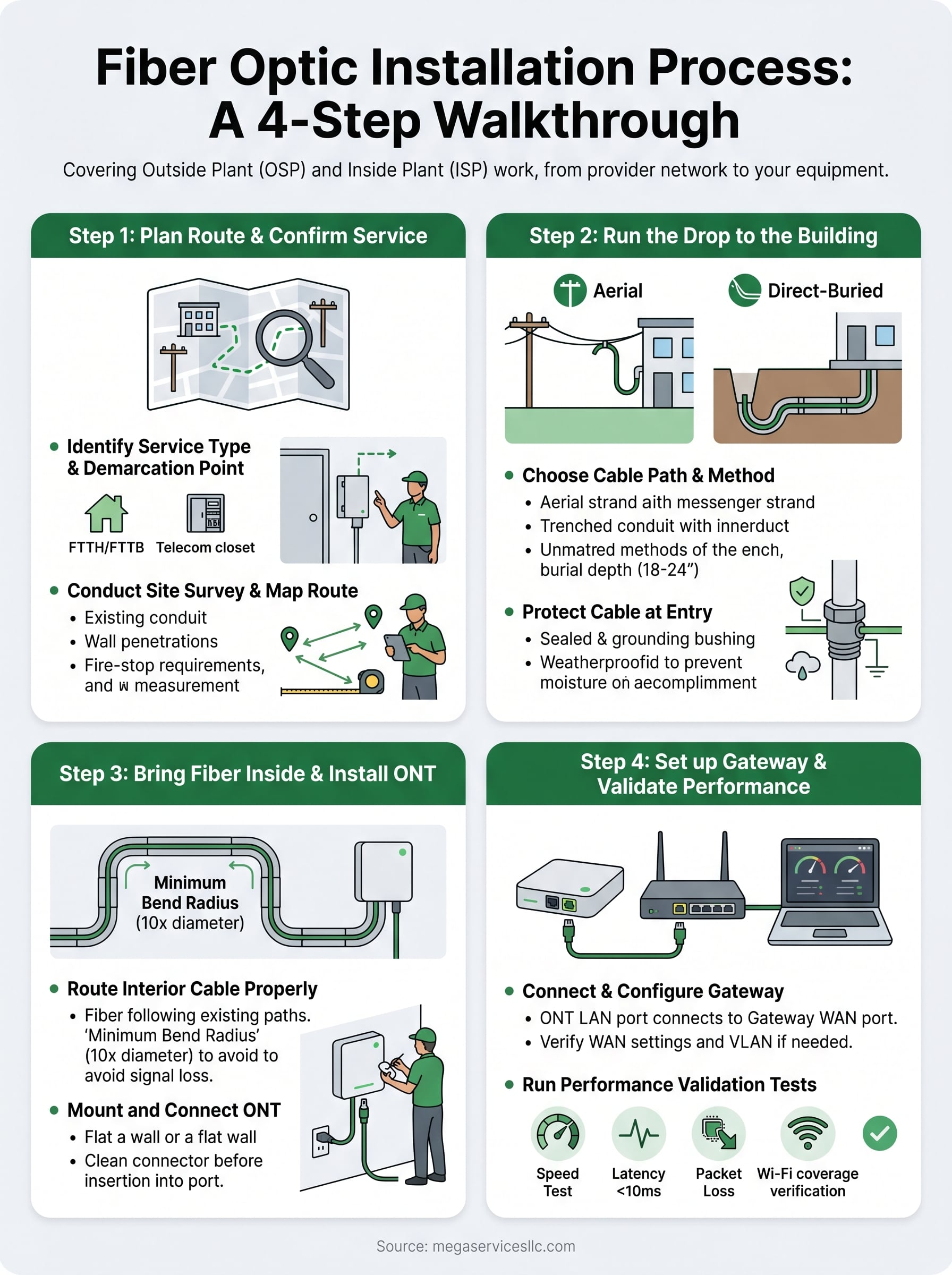

fiber optic installation process infographic

Wrap-up and next steps

The fiber optic installation process follows a clear sequence: confirm your service type, map the route, run the drop, install the ONT and gateway, and validate performance before you sign off. Each step builds on the last, and skipping any one of them creates problems that are harder and more expensive to fix after the fact.

Skilled technicians make the difference between a clean handoff and a costly rework call. MegaServices deploys vetted, certified technicians across the U.S. and Canada who handle structured cabling and fiber work for integrators and project managers who need reliable labor without long-term commitments. Whether you need one technician on-site tomorrow or a full crew across multiple locations, we can staff your project quickly and without the overhead of hiring full-time staff.

Ready to get your next fiber project staffed? Submit an information request and a MegaServices coordinator will reach out within one business day.

Mega Has The Staffing Solutions You Need For Your Next Pro AV Project.

Let MegaServices help you grow your business by providing you with the qualified personnel you need when you need them.

Mike Greckel

As a seasoned leader in the Pro AV industry, I bring over 17 years of experience driving successful projects through a network of trusted, handpicked freelance AV technicians. At Mega Services, where I proudly serve as CEO, we go beyond simply offering services—we deliver value, expertise, and reliability.
