How To Set Up A Server Room: Power, Cooling & Security

A poorly planned server room doesn’t just cause headaches, it causes downtime, equipment failures, and security vulnerabilities that ripple across your entire organization. Whether you’re building from scratch or redesigning an existing space, knowing how to set up a server room the right way means getting the power, cooling, cabling, and physical security right before the first rack goes in.

The challenge is that server room builds sit at the intersection of multiple disciplines: electrical, HVAC, structured cabling, and AV/IT infrastructure. Miss one piece, and you’re retrofitting later at two or three times the cost. At MegaServices, our nationwide network of certified technicians handles the low voltage structured cabling, rack-and-stack installations, and system commissioning that make server rooms functional from day one. We’ve supported builds and rollouts across the U.S. and Canada since 2007, so we’ve seen what works, and what fails when corners get cut.

This guide walks you through every phase of a server room setup: site selection, power planning, cooling design, cable management, rack layout, physical security, and ongoing maintenance. Each section covers practical decisions you’ll face during the build, with enough detail to help you spec the project correctly, communicate with contractors, and avoid the most common (and expensive) mistakes. Let’s get into it.

Prerequisites and design targets

Before you pull permits or order a single rack, you need to answer five foundational questions that drive every other decision in the build. Skipping this step is the most common reason server room projects run over budget. Understanding your current equipment inventory and your three-to-five-year growth projection shapes the power capacity you’ll need, the cooling load you’ll spec, and the square footage you’ll fight for when learning how to set up a server room the right way.

Getting your design targets wrong at the start costs far more to fix than getting them right before construction begins.

Know your load before you plan anything

Your first task is to calculate your total IT load in kilowatts (kW). Add up the power draw of every device you plan to install: servers, storage arrays, network switches, patch panels with active PoE, KVM systems, and any AV infrastructure like VTC endpoints or digital signage controllers. Pull the nameplate wattage from each device’s spec sheet, then apply a diversity factor of roughly 0.7 to 0.8, since most equipment does not run at full draw simultaneously. For example, if your nameplate total is 20 kW, your working design load is approximately 14 to 16 kW.

Rack density is the other calculation you need at this stage. A standard 42U rack loaded with 1U servers can hit 10 to 20 kW per rack in a dense deployment. Knowing your per-rack density tells you immediately whether standard perimeter cooling will work or whether you need in-row or rear-door cooling units.

Define your availability tier

Every server room sits somewhere on the Uptime Institute’s Tier I through Tier IV spectrum. Tier I means a single non-redundant path for power and cooling. Tier IV means fully fault-tolerant, concurrent maintainability with 99.995% uptime. Most small to mid-size server rooms target Tier II or Tier III, which requires redundant power paths and N+1 cooling at a minimum. Decide your tier before you write a single spec line, because it controls your budget more than almost any other factor in the project.

Build a design target worksheet

Before any contractor walks in the door, complete a design target worksheet. This forces every stakeholder to agree on the numbers that drive your budget and timeline, and it prevents the expensive back-and-forth that adds weeks to a project schedule.

ParameterYour TargetNotes
Total IT load (kW)Include 20% growth headroom
Rack count (now / 3-year)Plan positions for future racks
Availability tierTier I, II, III, or IV
Room floor area (sq ft)Min 100 sq ft for five or more racks
Raised floor or slabAffects cooling path design
Power feed voltage120V, 208V, or 480V
Redundant power (Y/N)Dual feeds, dual PDUs per rack
UPS runtime target (min)Typically 10 to 15 min to generator
Cooling typeCRAC, in-row, or rear-door
Physical security levelBadge only, biometric, or mantrap
Remote access requiredIPMI or out-of-band management

Fill every row before you engage an electrical contractor, a cabling crew, or a mechanical engineer. A signed-off worksheet eliminates scope creep and gives every trade a clear reference document throughout the build.

Understand local code requirements

Your local jurisdiction controls minimum electrical clearances, egress requirements, and fire suppression mandates for equipment rooms. The National Electrical Code (NEC), specifically Article 110, sets the baseline for working clearances around electrical panels and distribution equipment. NFPA 75 governs fire protection for IT equipment, including suppression system thresholds for rooms beyond a certain size and value.

Check both the NEC and NFPA 75 before you finalize your room selection or start any construction drawings. Your local Authority Having Jurisdiction (AHJ) may also layer on additional requirements around ventilation, seismic bracing, or hazardous material storage, so a pre-construction meeting with the AHJ saves you from costly change orders later.

Step 1. Choose the room and assess the site

The room you pick sets physical limits that no amount of equipment budget can overcome later. When figuring out how to set up a server room, your site selection is the single decision with the longest-lasting consequences. A room with inadequate structural capacity, poor electrical access, or a compromised envelope will constrain every other phase of the build, and retrofitting those deficiencies mid-project is expensive.

Evaluate structural and environmental conditions

Your building structure needs to support the dead load of fully loaded racks, which can reach 2,000 to 3,000 pounds each when you factor in servers, cable management, and a UPS on a floor-mount bracket. Before you commit to a space, get a structural engineer to verify the floor load rating in pounds per square foot (PSF). Most modern commercial buildings offer 100 to 150 PSF on concrete slabs, but older structures, raised floors, or mezzanine levels may fall short of what a dense rack row requires.

Beyond load, evaluate the room’s thermal envelope and moisture risk. Exterior walls introduce humidity swings and thermal transfer that fight your cooling system. Rooms below grade bring flood and condensation risk. Interior rooms on a building’s core, away from exterior walls and plumbing runs, are almost always the best choice. Also check for existing HVAC supply and return paths, since tying into a building’s main air handling system for a server room is rarely acceptable; you need dedicated cooling with independent controls.

A room that looks large enough on a floor plan often loses 30% of usable area once you account for clearances, power distribution, and cable pathways.

Check your power and cooling infrastructure

Walk the space with your electrical contractor and identify where your main electrical service enters the building and how far your server room sits from a viable distribution panel. Every additional foot of feeder run adds cost and voltage drop risk. Ideally, your room sits within 50 to 100 feet of a switchgear or distribution panel that can support a dedicated circuit for your full IT load.

Confirm the building’s available utility capacity at the same time. If your design target worksheet calls for 30 kW of IT load with N+1 UPS and redundant feeds, the utility needs to support that draw without upgrades to the incoming service. Your electrical contractor can pull the existing service capacity from the utility meter documentation, which tells you immediately whether you’re working within limits or need to budget for a service upgrade before a single rack gets delivered to the site.

Step 2. Plan racks, aisles, and clearances

Once your site is locked, your next task is to lay out the floor plan so every rack, aisle, and pathway has a defined position before installation begins. This is where most of the efficiency of your cooling system gets either built in or destroyed. Getting the rack layout right is one of the most impactful decisions you’ll make when learning how to set up a server room, because mistakes here force you to physically move heavy, loaded equipment after the fact, which is exactly the kind of rework that blows project timelines.

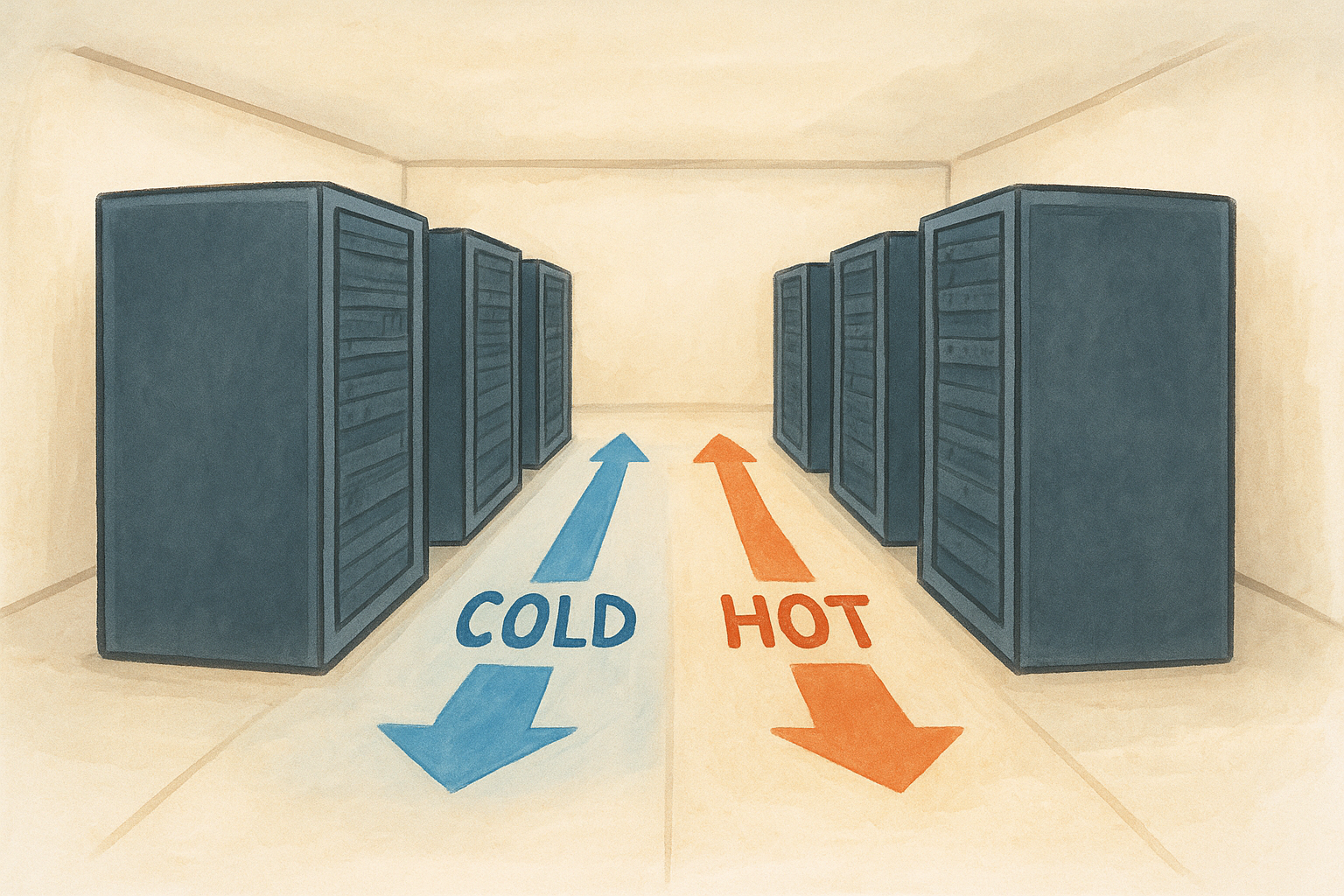

Adopt a hot aisle/cold aisle layout

The most proven rack arrangement is the hot aisle/cold aisle configuration, where rack rows alternate between facing each other front-to-front (cold aisle) and back-to-back (hot aisle). Cold supply air from your computer room air conditioning (CRAC) units flows into the cold aisle and enters equipment from the front. Hot exhaust exits the rear into the hot aisle, where your cooling units capture and return it. This separation prevents hot and cold air from mixing, which cuts your cooling system’s workload and protects your equipment from thermal stress.

Adopt a hot aisle/cold aisle layout

A properly implemented hot aisle/cold aisle layout can reduce cooling energy consumption by 20 to 40% compared to a random rack arrangement.

Use the table below to confirm your aisle widths and clearances before the installation crew positions a single rack:

DimensionMinimumRecommended
Cold aisle width42 inches48 inches
Hot aisle width36 inches42 inches
Rear clearance to wall24 inches36 inches
Side clearance (end of row)24 inches36 inches
Overhead cable tray height12 inches above rack top18 inches above rack top

Mark rack positions before equipment arrives

Before any equipment hits the loading dock, mark every rack position on the floor using blue painter’s tape or permanent floor marking tape. Label each position with the rack ID from your design drawings so the installation crew places each unit exactly where it belongs the first time. Confirm your structural anchor points at the same time, since seismic and anti-tip floor anchoring is required in most jurisdictions and must align with the structural assessment you completed in Step 1.

Also verify that your power distribution units (PDUs) fit within your chosen rack depth before you place the order. Standard racks run 29 to 33 inches deep, but vertical PDUs and rear cable managers can reduce usable depth by 2 to 4 inches. Order racks and PDUs together so you know exactly what fits before installation day arrives.

Step 3. Build a safe power system

Power is the foundation that everything else in your server room depends on. A single miscalculated circuit or an undersized UPS turns a minor utility blip into a major outage, which is exactly why experienced teams treat power planning as a non-negotiable first phase of any build. When you understand how to set up a server room correctly, you approach power infrastructure with the same rigor you’d apply to the equipment it supports.

Size your UPS and electrical circuits

Your uninterruptible power supply (UPS) needs to cover your full IT load plus a 20 to 25% overhead buffer for future expansion. Take the total design load from your worksheet in kilowatts and convert it to volt-amperes (VA) by dividing by a typical power factor of 0.9. For example, a 14 kW design load requires a UPS rated for approximately 15,600 VA. Most data center-grade UPS systems ship in 10 kVA, 20 kVA, and 40 kVA configurations, so size up to the next tier when your calculated requirement lands close to a boundary.

Selecting a UPS at 90% or more of its rated capacity leaves no headroom for inrush current spikes when servers restart simultaneously after maintenance.

Match your circuit sizing to your PDU requirements, not just your device nameplates. Each dedicated branch circuit feeding a PDU should carry no more than 80% of its rated amperage under continuous load, per NEC Article 210.20. A 30-amp circuit handles a continuous load of 24 amps maximum. Use the table below to map common PDU configurations to their safe continuous load limits:

Circuit RatingSafe Continuous Load (80%)Typical PDU Use Case
20A / 120V16A / 1.9 kWLight-density rack, 1 to 3 servers
30A / 208V24A / 5 kWMid-density rack, 4 to 8 servers
60A / 208V48A / 10 kWHigh-density rack, 10+ servers

Install redundant power distribution

Redundancy at the PDU level protects your equipment when a single circuit trips or a PDU fails during operation. Deploy two separate PDUs per rack fed from independent circuits and, where possible, independent UPS modules. Every server you install should have its dual power supplies connected to opposite PDUs so that losing one feed does not interrupt the device.

Install redundant power distribution

Label every PDU, circuit breaker, and power cable with a consistent naming convention before you rack a single device. Clear labeling cuts troubleshooting time dramatically during incidents and ensures your maintenance team can isolate any single circuit without guessing which breaker controls which rack.

Step 4. Design cooling and airflow

Your power system delivers the electricity, but cooling keeps that electricity from destroying your equipment. Heat is the leading cause of premature hardware failure in server rooms, and no amount of high-quality gear compensates for inadequate airflow management. Getting cooling right is a non-negotiable step when you understand how to set up a server room that stays online reliably.

Calculate your cooling load

Converting your total IT load to BTUs per hour is the first calculation you need before you spec a single cooling unit. Multiply your design load in kilowatts by 3,412 to get your heat output. A 14 kW room produces approximately 47,768 BTU/hr that your cooling system must remove continuously. Add a 25% safety margin for lighting, personnel, and UPS heat dissipation inside the room, which brings that example room to roughly 59,710 BTU/hr of required cooling capacity.

Undersizing your cooling unit by even 10 to 15% leads to progressive heat buildup during peak loads, which shortens equipment lifespan faster than almost any other single factor.

IT Load (kW)Heat Output (BTU/hr)Recommended Capacity (with 25% margin)
5 kW17,060 BTU/hr21,325 BTU/hr
10 kW34,120 BTU/hr42,650 BTU/hr
20 kW68,240 BTU/hr85,300 BTU/hr

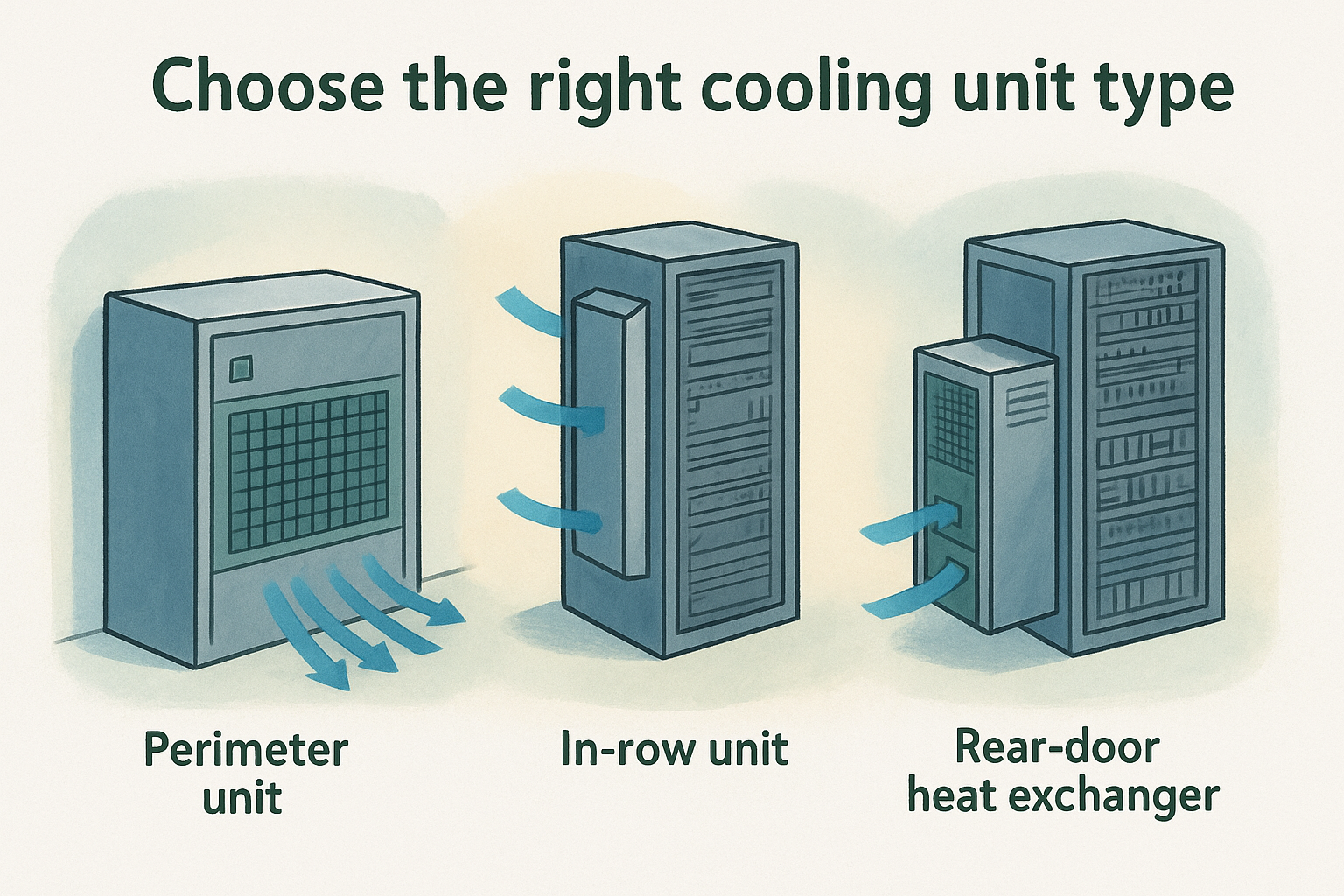

Choose the right cooling unit type

Three main computer room air conditioning (CRAC) configurations cover the majority of server room deployments: perimeter units, in-row units, and rear-door heat exchangers. Perimeter CRAC units work well for low to mid-density rooms under 10 kW per rack, where the distance from the unit to the rack face stays short enough for effective cold air delivery. In-row units mount directly between rack rows and serve denser deployments where perimeter cooling cannot deliver enough airflow to hot spots without significant bypass.

Choose the right cooling unit type

Rear-door heat exchangers attach directly to the back of each rack and capture heat at the source before it enters the hot aisle. This approach works particularly well for high-density deployments above 15 kW per rack, but requires a chilled water loop or refrigerant circuit that adds mechanical complexity to your build.

Control humidity and monitor conditions

Your target humidity range is 40 to 55% relative humidity, following ASHRAE guidelines for IT equipment environments. Too little humidity generates static discharge that damages components; too much causes condensation on circuit boards. Install dedicated environmental monitoring sensors at multiple rack heights so your management system catches temperature or humidity excursions before they become failures.

Step 5. Install structured cabling and pathways

Cabling mistakes are invisible until they cause problems, and by then your racks are loaded, your pathways are buried, and fixing a bad run means pulling half your infrastructure apart. Structured cabling is where long-term reliability gets built or destroyed, so plan every pathway, cable category, and termination point before the first cable comes off the spool. This is one of the most technically specific phases of how to set up a server room, and getting it right requires discipline in materials, routing, and documentation.

Select the right cable category and media type

Cat6A is the current baseline for new server room horizontal runs. It supports 10 Gbps at full 100-meter distances and handles the higher frequencies that modern switches and servers demand. Cat6 (without the A) works for 1 Gbps links but drops to 55-meter limits for 10 Gbps, which causes problems in larger rooms. For inter-rack backbone and uplinks to core switching, use multi-mode OM4 or OM5 fiber, which supports 40 Gbps and 100 Gbps at typical server room distances without the cost of single-mode.

Running Cat6A and fiber backbone in the same build future-proofs your horizontal infrastructure for at least one full equipment refresh cycle.

Route pathways and manage cables properly

Your overhead cable tray is your primary horizontal pathway for data cabling, and it must stay physically separate from your power distribution pathways by at least 12 inches to prevent electromagnetic interference. Route your data tray down the cold aisle side above the racks. Run vertical cable managers inside each rack to keep patch cords off the equipment faces and off the floor. J-hooks work well for branch runs off the main tray when you need to drop cables to a specific rack or wall port.

Keep patch cord lengths tight and consistent inside each rack. A standard kit of 1-foot, 2-foot, and 3-foot patch cords covers most rack-level connections without leaving loose loops of excess cable that block airflow and make troubleshooting harder.

Label every run before you close anything

Follow TIA-606 labeling standards for every cable, patch panel port, and wall outlet. Label both ends of every run before you terminate it, not after. Use printed labels on a label maker, not handwritten tags that fade or fall off under repeated maintenance. A consistent naming format gives any technician an immediate read on where a cable originates and terminates:

Label ComponentExampleMeaning
Rack IDA1Row A, first rack
Panel and portP01Port 1 on the patch panel
Full label formatRACK-A1-P01Row A, rack 1, port 01

Your outside crews handling moves and changes depend on accurate labeling to work efficiently and avoid accidental disconnections.

Step 6. Set up networking and remote access

Networking is the layer that connects every device in your server room to the systems and users that depend on them. Before you plug in a single switch, define your VLAN segmentation strategy and IP addressing scheme so that every device lands on the right network segment from day one. Retrofitting network architecture after racks are loaded and services are live is one of the most disruptive changes you can make, and it’s entirely avoidable when you plan this phase properly as part of how to set up a server room.

Configure your core switching architecture

Your top-of-rack (ToR) switches handle all device-to-device traffic within each rack, while your core switch aggregates uplinks from every ToR into a central point. Connect ToR switches to your core with at least two uplinks bonded into a link aggregation group (LAGG) for both redundancy and throughput. This prevents a single cable or port failure from isolating an entire rack’s worth of equipment during production hours.

A flat, unstructured network with no VLAN separation is one of the fastest ways to introduce broadcast storms and security gaps into an otherwise well-built server room.

Use the table below as a baseline VLAN framework you can adapt to your environment:

VLAN IDPurposeTypical Devices
10Production serversApplication and database servers
20ManagementIPMI, iDRAC, iLO interfaces
30StorageSAN, NAS, iSCSI targets
40Out-of-bandSerial console servers, KVM switches
50Guest / testDevelopment and staging systems

Assign dedicated management IPs from VLAN 20 to every server’s out-of-band management interface before you deploy an operating system. This lets you power cycle, access the BIOS, or recover a hung system remotely without touching the production network.

Enable out-of-band management

Out-of-band management gives your team hardware-level access to every server regardless of whether the operating system is responsive. Most enterprise servers ship with a dedicated management controller, such as Dell’s iDRAC, HP’s iLO, or Supermicro’s IPMI interface. Connect each controller to a dedicated management switch on VLAN 20 and assign static IPs using a consistent naming scheme so any technician can identify the correct device immediately.

Your remote access documentation should capture every management IP, hostname, and credential location in a secure, access-controlled location. Use the format below as a minimum record for each managed device:

FieldExample Value
Hostnamesrv-prod-01
Management IP10.20.0.11
VLAN20
Controller typeiDRAC 9
Credential locationVault / secrets manager

Step 7. Lock down physical security and safety

Physical security is the layer most teams underinvest in when they learn how to set up a server room, and that gap creates risk that no firewall or encryption policy can compensate for. Unauthorized physical access to your servers means an attacker can bypass every software control you have in under five minutes, whether they’re stealing storage drives, planting hardware keyloggers, or simply pulling power to critical systems. Treat your server room as a restricted zone with documented, enforced access controls from the first day of operation.

Control who enters the room

Your first line of defense is a door access control system that requires authenticated credentials to enter. Proximity card readers work for most environments, while biometric readers add a second factor in higher-security deployments. For rooms that store sensitive customer data or fall under compliance frameworks like PCI-DSS or HIPAA, consider a mantrap vestibule that requires one door to close before the next opens, preventing tailgating entirely.

Control who enters the room

Shared PIN codes and propped-open doors are the two most common physical security failures in server rooms, and both are policy problems, not technology problems.

Maintain a digital access log that records every entry and exit with a timestamp and credential identifier. Review that log on a weekly basis at a minimum, and set up automated alerts for access attempts outside normal business hours. Remove credentials immediately when a technician or employee’s role changes or they leave the organization.

Monitor and detect threats inside the room

Access control keeps unauthorized people out, but interior monitoring catches what happens once someone is inside. Install IP cameras with a minimum resolution of 1080p covering the door, rack rows, and power distribution panels. Retain footage for at least 90 days and store it off-site or on a system outside the server room itself so an incident inside the room does not destroy the evidence.

Complement cameras with door contact sensors and motion detectors connected to your building management or security information system. These sensors generate alerts when a door is held open beyond a threshold or when motion occurs outside of scheduled maintenance windows.

Address fire suppression and safety compliance

Your server room needs a clean agent fire suppression system rather than a standard water sprinkler. Clean agent systems, such as FM-200 or Novec 1230, suppress fires without damaging equipment or creating electrical hazards. Verify that your system meets the requirements in NFPA 75 and that your local AHJ has signed off on the installation before you bring any equipment online.

Install smoke and early-warning fire detectors at both the floor level and ceiling level inside the room. Floor-level detection catches smoldering cable fires that standard ceiling detectors miss until the situation is already serious.

Step 8. Commission, document, and maintain

Commissioning is the verification phase that confirms every system you built actually performs to spec before you hand the room over to production traffic. Skipping formal commissioning is how teams discover critical gaps six months after go-live, when the cost of fixing them is far higher than it would have been during the build. This final step in how to set up a server room turns a collection of installed equipment into a documented, testable, and maintainable infrastructure.

Run a structured commissioning checklist

Your commissioning process should follow a written checklist that covers every system in sequence: power, cooling, cabling, networking, security, and fire suppression. Test each system independently before you test them together under load. Power on your UPS and confirm it transfers cleanly during a simulated utility outage. Verify that each PDU circuit reads the correct amperage under a test load before any servers connect.

A commissioning checklist that lives only in someone’s head is not a commissioning checklist; it is a liability.

Run a full load test at your design target wattage for a minimum of four hours and monitor your inlet and exhaust temperatures throughout. Confirm that every rack’s inlet air stays at or below 80.6°F (27°C), the upper threshold in ASHRAE’s A1 equipment class. Document your temperature readings at the top, middle, and bottom of each rack so you have a baseline for future comparisons.

Build your documentation package

Your as-built documentation package is what keeps your server room maintainable when the original install crew is no longer on site. At a minimum, your package should include the items listed below:

  • Rack elevation diagrams showing every device’s position and assigned rack unit
  • Cable run sheets with both endpoints, cable category, and label ID for every run
  • Network diagrams showing VLAN assignments, switch port mappings, and uplink paths
  • Power distribution maps showing which PDU and circuit feeds each device
  • UPS and cooling unit settings, serial numbers, and warranty expiration dates
  • Access control credential inventory with assigned personnel and permission levels

Store one copy locally in a fireproof enclosure and one copy in a secure off-site or cloud location. Update the package within 48 hours of any change to the physical or logical infrastructure.

Set a preventive maintenance schedule

Reactive maintenance costs more than preventive maintenance in every measurable way. Build a recurring maintenance calendar that covers the tasks below at the intervals shown:

TaskFrequency
Review UPS battery health and runtime testQuarterly
Clean CRAC unit filters and check refrigerant levelsQuarterly
Inspect cable trays and patch panels for loose connectionsSemi-annually
Audit access control logs and revoke stale credentialsMonthly
Review temperature and humidity baseline against current readingsMonthly

Assign a named owner to each maintenance task so accountability is clear and nothing falls through the gaps between team members.

how to set up a server room infographic

Ready to put your server room into service

You now have a complete roadmap covering every phase of how to set up a server room, from site selection and power planning through cooling, cabling, networking, security, and commissioning. Each step builds on the previous one, and skipping any phase creates the kind of expensive, disruptive rework that pushes projects over budget and behind schedule.

The structured cabling, rack installation, and commissioning phases are where most builds benefit from certified field technicians who have completed this work across dozens of deployments. MegaServices deploys vetted, certified low voltage and AV technicians nationwide within 24 to 48 hours, so your project stays on schedule regardless of location.

When you’re ready to bring qualified technical labor onto your server room build, request technician support from MegaServices and get the right crew on-site fast. Your timeline and budget depend on getting this step right from day one.

Mega Has The Staffing Solutions You Need For Your Next Pro AV Project.

Let MegaServices help you grow your business by providing you with the qualified personnel you need when you need them.

Mike Greckel

As a seasoned leader in the Pro AV industry, I bring over 17 years of experience driving successful projects through a network of trusted, handpicked freelance AV technicians. At Mega Services, where I proudly serve as CEO, we go beyond simply offering services—we deliver value, expertise, and reliability.
