8 Structured Cabling Best Practices For Future-Ready IT

A poorly planned cable infrastructure doesn’t just cause headaches on install day, it creates years of costly service calls, network downtime, and frustrated end users. Whether you’re pulling cable through a new corporate headquarters or retrofitting a 200-location retail chain, following structured cabling best practices separates a system that lasts a decade from one that needs rework in two years. The stakes are high, and the margin for error is slim, especially when project timelines are measured in days, not weeks.

At MegaServices, our technicians have installed and serviced structured cabling systems across thousands of sites in the U.S. and Canada since 2007. We’ve seen firsthand what works, what fails, and what shortcuts come back to haunt a project months later. That hands-on experience across diverse environments, from conference rooms to distribution centers, is exactly what shaped this guide.

Below, we break down eight proven practices that AV integrators, project managers, and service coordinators can apply right now to build cabling infrastructure that’s organized, reliable, and ready for whatever technology comes next.

1. Use nationwide certified cabling labor on demand

Your project timeline collapses the moment you can’t staff a qualified technician at a specific location on short notice. Certified cabling labor is the foundation of every other structured cabling best practice on this list, because even the best design fails when the hands executing it lack the right credentials and experience. Sourcing that labor efficiently, across multiple markets at once, determines whether your project stays on schedule.

What to do

Partner with a nationwide labor provider that maintains a vetted network of low-voltage and cabling technicians who hold relevant certifications such as BICSI RCDD, BICSI Installer 2, or manufacturer-specific credentials. Confirm that your labor source can deploy technicians within 24 to 48 hours to both primary metro areas and secondary markets, since multi-site rollouts rarely cluster around major cities. Request documentation of certifications before any technician steps on site.

Why it matters

Uncertified or undertrained technicians produce work that fails certification testing, violates TIA/EIA standards, and voids manufacturer warranties on cable and connectivity components. Rework costs on a failed structured cabling installation typically run two to three times the original labor expense once you factor in material waste, additional site visits, and project delays.

Certified technicians don’t just install cable correctly the first time, they also catch design conflicts and pathway issues before they become expensive problems.

Common mistakes to avoid

Many project managers assume that any low-voltage electrician can handle structured cabling. That assumption creates real risk. Avoid these errors on your next deployment:

  • Hiring general electricians without specific low-voltage or data cabling experience
  • Skipping credential verification to save time during onboarding
  • Using different labor sources per region without a unified quality standard
  • Failing to confirm that technicians carry the required insurance and have passed background checks

Field checklist

Before your first technician mobilizes, confirm each item below is in place:

  • Certifications verified and on file
  • Background check completed
  • Site-specific safety requirements reviewed and acknowledged
  • Scope of work document signed and distributed
  • Testing equipment (such as a Fluke DSX CableAnalyzer) confirmed available on site
  • Escalation contact at the labor provider identified for day-of issues

2. Design around a standards-based cabling architecture

Every reliable cabling project starts with a standards-based design, not a contractor’s personal preference or a budget shortcut. Following TIA-568 and ISO/IEC 11801 gives your infrastructure a consistent framework that every technician, from first install to future maintenance, can work from without guesswork.

What to do

Base your design on current TIA-568 standards for horizontal cabling, backbone cabling, and telecommunications room layout. Define your topology, document pathway routing, and specify connector types before the first cable reel arrives on site. Treat the design phase as a non-negotiable deliverable, not a step you refine on the fly.

Why it matters

Standards-based architecture is the backbone of every structured cabling best practice in this guide. When your design references recognized standards, equipment manufacturers honor warranties, inspectors clear the work faster, and future integrators can expand the system without starting over.

A design built on published standards protects your client’s investment and keeps your project out of costly rework cycles.

Common mistakes to avoid

Skipping the design phase or rushing through it creates costly downstream problems that surface during testing or after turnover. Watch for these common errors that derail even well-funded projects:

  • Mixing horizontal and backbone cable specs without documentation
  • Ignoring pathway capacity when planning conduit and cable tray runs
  • Failing to reference the current version of TIA-568

Field checklist

Run through this checklist before locking your design and submitting it for approval. Missing even one item creates gaps in documentation that slow down testing and turnover:

  • Design documents reference TIA-568 or ISO/IEC 11801
  • Pathway routing and rack elevations drawn and approved
  • Cable specifications locked before procurement

3. Choose the right cable and fiber for each link

Selecting the wrong cable category or fiber type is an avoidable mistake with real performance consequences. The cable specification you lock in during design determines what bandwidth, distance, and technology your infrastructure can support over the next 10 to 15 years.

What to do

Match cable type to the performance requirements of each link. Use Cat 6A for horizontal runs supporting 10GbE or high-power PoE devices, and specify single-mode fiber for backbone runs exceeding 100 meters or connecting separate buildings. Confirm all selections meet current TIA-568 channel requirements before procurement.

Why it matters

Undersized cable forces expensive rework when your client upgrades network hardware. Cat 5e and Cat 6 cannot reliably support 10GbE over full 100-meter runs, and retrofitting a live facility costs far more than specifying Cat 6A upfront. Getting cable selection right is one of the most impactful structured cabling best practices you can apply.

Choosing cable based on today’s budget rather than tomorrow’s bandwidth requirements is the fastest way to schedule a return visit you won’t get paid for.

Common mistakes to avoid

Small specification errors create large problems during testing and after turnover. Watch for these issues on your next project:

  • Specifying Cat 6 instead of Cat 6A for environments with high-power PoE devices or wireless access points
  • Mixing multimode and single-mode fiber without documenting transition points
  • Ignoring plenum-rated jacket requirements in air-handling spaces

Field checklist

Lock these items down before your cable order ships to avoid on-site substitutions that compromise performance:

  • Cable category confirmed against TIA-568 channel requirements
  • Fiber type (OM4, OM5, or OS2) matched to link distance
  • Plenum or riser rating verified before procurement

4. Plan telecom rooms, racks, and pathways early

Telecom room locations, rack layouts, and pathway routes decided late in a project create physical constraints that no amount of skilled labor can fix after construction closes in. Locking these elements down early is one of the most practical structured cabling best practices you can apply before a single cable ships.

4. Plan telecom rooms, racks, and pathways early

What to do

Identify telecommunications room (TR) locations during the design phase, sized to TIA-569 standards with adequate clearance, power, cooling, and access. Map conduit runs, cable trays, and sleeve penetrations on architectural drawings before construction begins, and confirm pathway capacity supports your cable count with room for future expansion.

Why it matters

Pathways that fill up on day one leave no room for adds, moves, and changes without disruptive rework. Undersized telecom rooms force technicians to compromise on bend radius, airflow, and cable management, all of which degrade performance over time.

Every pathway and room decision you delay becomes a change order you pay for later.

Common mistakes to avoid

Late planning creates problems that cascade through every phase of the project:

  • Ignoring conduit fill ratios per NEC Article 358
  • Sizing racks without leaving one to two units of buffer space per rack for future patch panels
  • Routing cable trays through high-heat zones or conflict pathways

Field checklist

Run through this checklist before construction closes to avoid costly mid-project changes:

  • TR locations sized per TIA-569
  • Conduit and tray routes marked on approved drawings
  • Rack elevations finalized and submitted for review

5. Install for performance, not just for continuity

A cable that passes a continuity check is not the same as a cable installed to channel performance standards. Many installations get this wrong by treating physical connectivity as the finish line when it’s really just the starting point. True structured cabling best practices require that every pull, termination, and tie-wrap decision supports the full rated performance of the channel.

What to do

Maintain proper bend radius throughout every horizontal run, keep untwist at terminations to under 13mm for Cat 6A, and avoid over-cinching cable ties that deform the jacket. Dress cables neatly in trays with consistent spacing so you’re not compressing the pairs of adjacent runs against each other.

Why it matters

Alien crosstalk and pair distortion are the most common causes of channel failures on Cat 6A runs, and both stem directly from poor installation technique rather than bad cable. A single over-tightened cable tie can push a borderline run below the TIA-568 insertion loss threshold.

Technicians who install to performance standards instead of minimum continuity produce systems that pass certification on the first attempt, not the third.

Common mistakes to avoid

  • Bundling horizontal runs too tightly with standard zip ties instead of hook-and-loop fasteners
  • Exceeding the 4-pair untwist limit at keystone jacks to gain slack
  • Pulling cable above its maximum tension rating through conduit

Field checklist

Check every item below before your crew moves off the floor. Skipping one step here often means a failed certification run and an unplanned return visit.

  • Bend radius maintained throughout every run
  • Untwist at terminations confirmed under 13mm
  • Hook-and-loop fasteners used in trays and racks

6. Label and document everything from day one

Documentation is not a project closeout task, it’s a continuous practice that starts the moment your crew begins pulling cable. Without a complete labeling and documentation system in place from day one, even a technically flawless installation becomes a liability the moment anyone needs to troubleshoot, add a run, or hand the system off to a new team.

What to do

Apply TIA-606 compliant labels to every cable end, patch panel port, faceplate, and rack unit before the run is terminated. Maintain an as-built record in a cable management system or structured spreadsheet that maps each cable ID to its origin, destination, length, and test result. Update that record in real time, not at the end of the week.

Why it matters

Unlabeled infrastructure wastes time and money on every future service call. Technicians troubleshooting a mislabeled or undocumented run spend hours tracing cable that a clear label would have resolved in minutes. Following this structured cabling best practice also protects you during warranty claims, since manufacturers often require traceability back to the original installation record.

Accurate documentation is what separates a maintainable system from an expensive guessing game.

Common mistakes to avoid

  • Labeling only one end of each cable run
  • Using hand-written labels instead of printed, heat-resistant labels rated for the environment
  • Treating as-built documentation as optional until the client requests it

Field checklist

  • TIA-606 labels applied to both ends of every run
  • As-built records updated daily during installation
  • Rack and panel documentation submitted before project closeout

7. Test and certify every run before turnover

Passing certification testing before you hand over a project is not optional, it’s the final proof that your installation meets channel performance standards. Without documented test results, your client has no baseline for future troubleshooting, and you have no defense when a performance issue surfaces months after turnover.

7. Test and certify every run before turnover

What to do

Use a field tester rated for the installed cable category, such as a Fluke DSX CableAnalyzer, and run a full suite of TIA-568 tests on every link. Capture pass/fail results, generate a project-level report, and deliver that report to your client as part of the formal closeout package.

Why it matters

Certification testing is one of the most overlooked structured cabling best practices, yet it’s the only way to confirm the entire channel performs to spec under real conditions. A visual inspection catches obvious physical defects, but it misses alien crosstalk, insertion loss failures, and impedance discontinuities that only appear under load.

Certified test results give your client proof of performance and protect you against warranty disputes that surface after the project closes.

Common mistakes to avoid

Small shortcuts during testing create major liability after turnover. Avoid these errors before you demobilize:

  • Testing only a sample of runs instead of every link
  • Failing to save raw test data alongside PDF reports
  • Using a tester that is not rated for the installed category

Field checklist

Confirm each item below before your crew leaves the site:

  • Full-suite TIA-568 tests run on every link
  • Raw test files and PDF reports archived
  • Client-signed closeout report delivered before demobilization

8. Maintain cable health with audits and change control

A structured cabling installation doesn’t manage itself after turnover. Physical changes, undocumented moves, and gradual component wear degrade even the best-built systems over time, and without a formal process to track those changes, your infrastructure drifts further from its original certified state with every service call.

What to do

Schedule periodic cable audits at least once a year for active enterprise environments, and enforce a change control process that requires any new run, patch change, or device move to be documented before the technician leaves the site. Use your as-built records from day one as the baseline every audit checks against.

  • Assign a named owner for the change control log
  • Re-certify any run disturbed during renovations or equipment swaps

Why it matters

Undocumented changes are the leading cause of cable plant degradation in facilities with active IT teams. Each undocumented move creates a gap between your certified baseline and reality, and those gaps compound until a major network event forces a full re-audit at serious cost. Following this structured cabling best practice keeps that baseline intact.

Treating change control as bureaucratic overhead is exactly what turns a well-built infrastructure into an unmanageable one.

Common mistakes to avoid

Skipping routine audits until a failure forces the issue costs far more than the audit itself would have. Avoid these errors to protect your cable plant long-term:

  • Allowing any team member to make patch changes without logging them
  • Failing to re-test runs disturbed during facility renovations

Field checklist

Confirm these items are in place before you close out ongoing maintenance responsibilities:

  • Annual audit scheduled and assigned to a responsible technician
  • Change control log maintained and accessible to all relevant teams
  • Modified runs re-certified and records updated

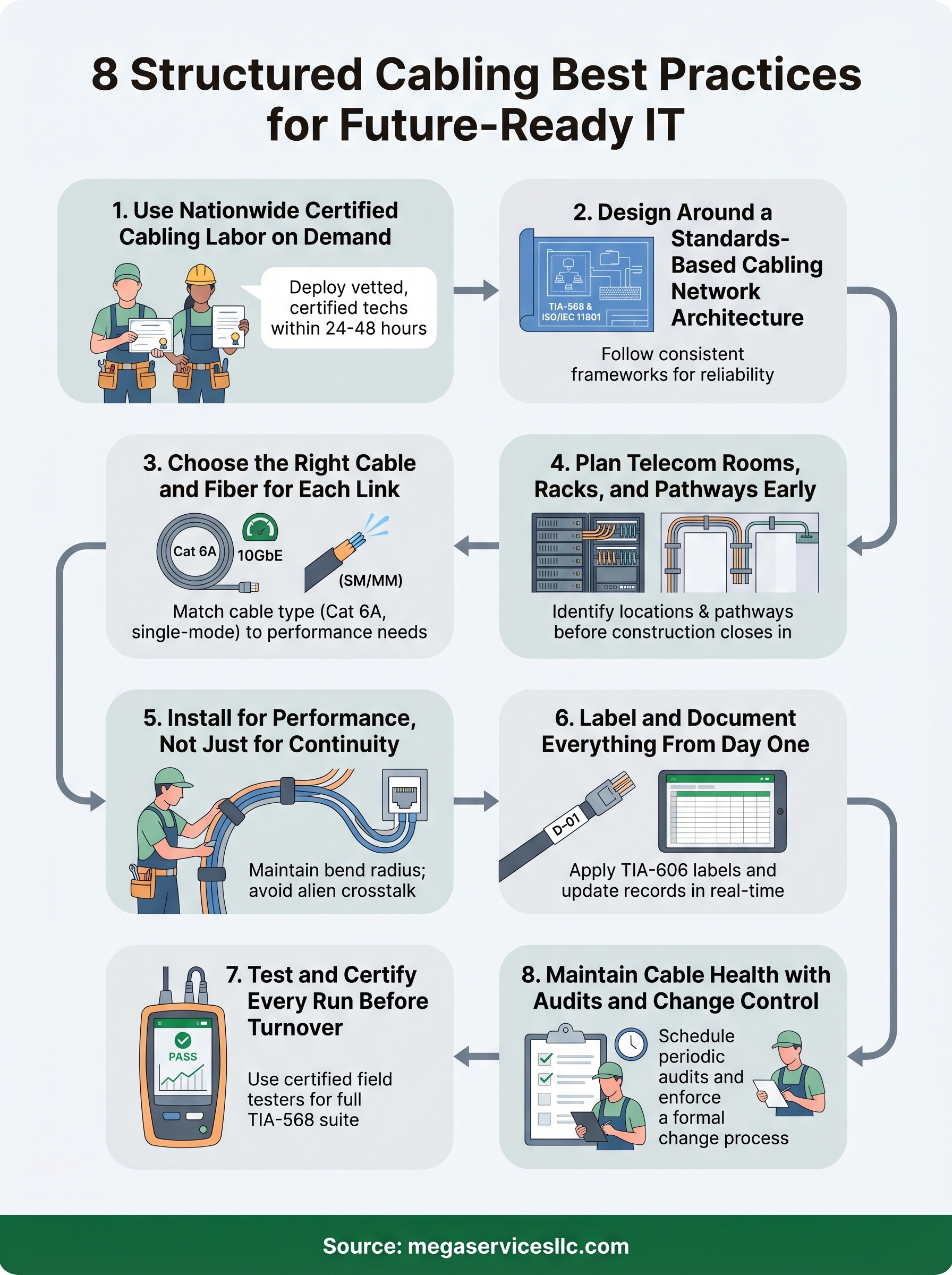

structured cabling best practices infographic

Quick recap and next steps

These eight structured cabling best practices cover every phase of a project, from hiring certified labor and designing to standards, all the way through testing, documentation, and long-term maintenance. Apply all eight consistently and you build infrastructure that performs on day one and holds up through years of changes, upgrades, and heavy use.

The single variable that influences every item on this list is the quality of the technicians doing the work. Skilled, certified labor executes the design correctly, catches problems early, and produces test results that hold up. Without that, even the best plan falls apart in the field.

Your next project doesn’t have to wait weeks for qualified technicians. MegaServices deploys vetted, certified cabling and low-voltage technicians across the U.S. and Canada within 24 to 48 hours, with no contracts or minimums required. Request your structured cabling labor today and keep your timeline intact.

Mega Has The Staffing Solutions You Need For Your Next Pro AV Project.

Let MegaServices help you grow your business by providing you with the qualified personnel you need when you need them.

Mike Greckel

As a seasoned leader in the Pro AV industry, I bring over 17 years of experience driving successful projects through a network of trusted, handpicked freelance AV technicians. At Mega Services, where I proudly serve as CEO, we go beyond simply offering services—we deliver value, expertise, and reliability.
